Current and Upcoming CIP Intersection Improvements 2026-2027
League City Parkway and Calder Road
The project consists of the addition of a right-turn lane to the existing pavement along League City Parkway, from west of Butler Road to east of Calder Road. The project spans approximately 0.38 miles, including the construction of 12-foot right turn lane, traffic signal modifications with intersection sidewalk improvements, and median modifications to an S-median.
Capital Improvement Project Budget: $2,023,051
Project Timeline:
- Current Status: Construction July 2025
- Design Phase: Completed May 2024
- Bid Phase: February 2025
- Substantial Completion: Anticipated March 2026

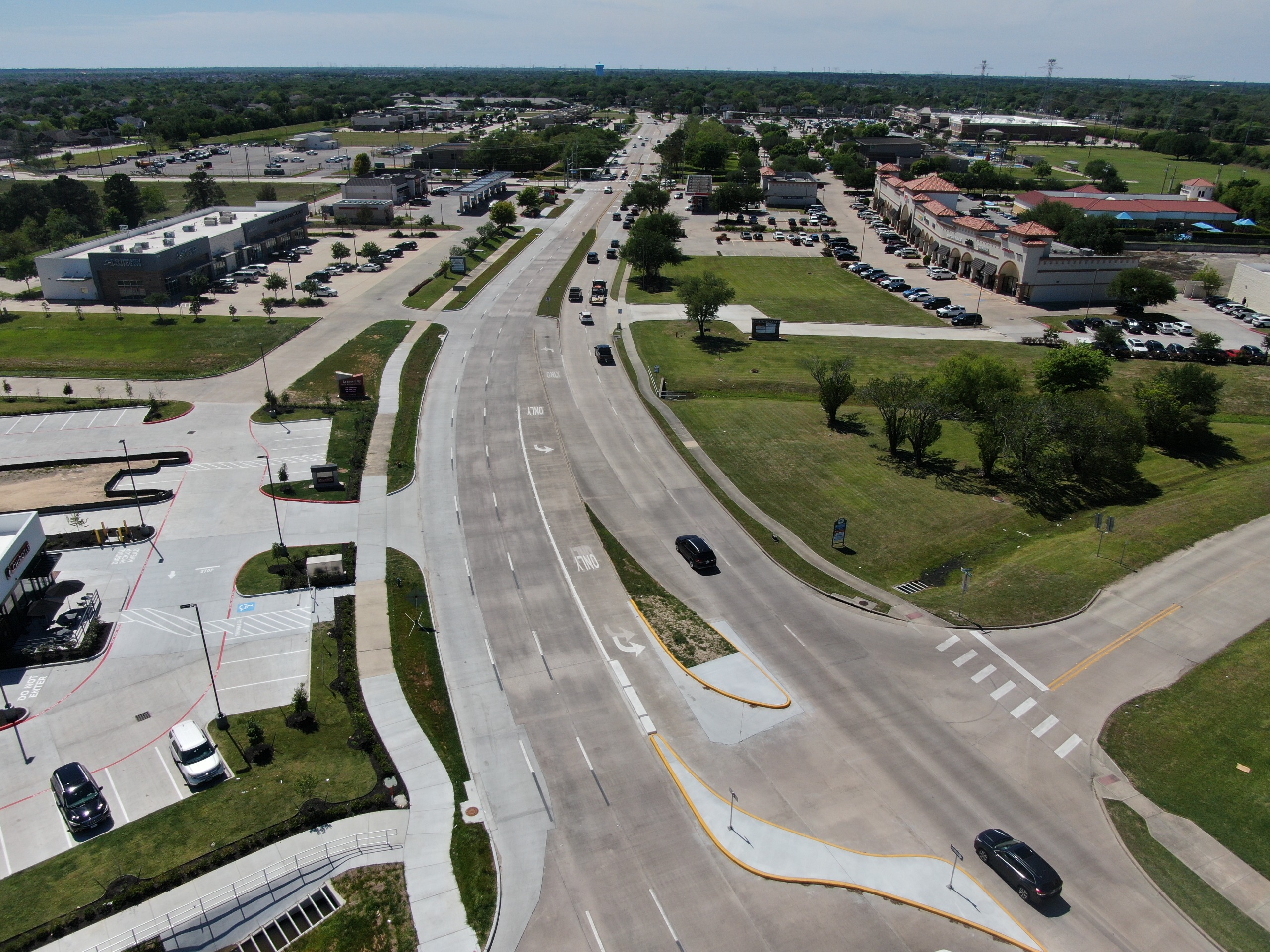

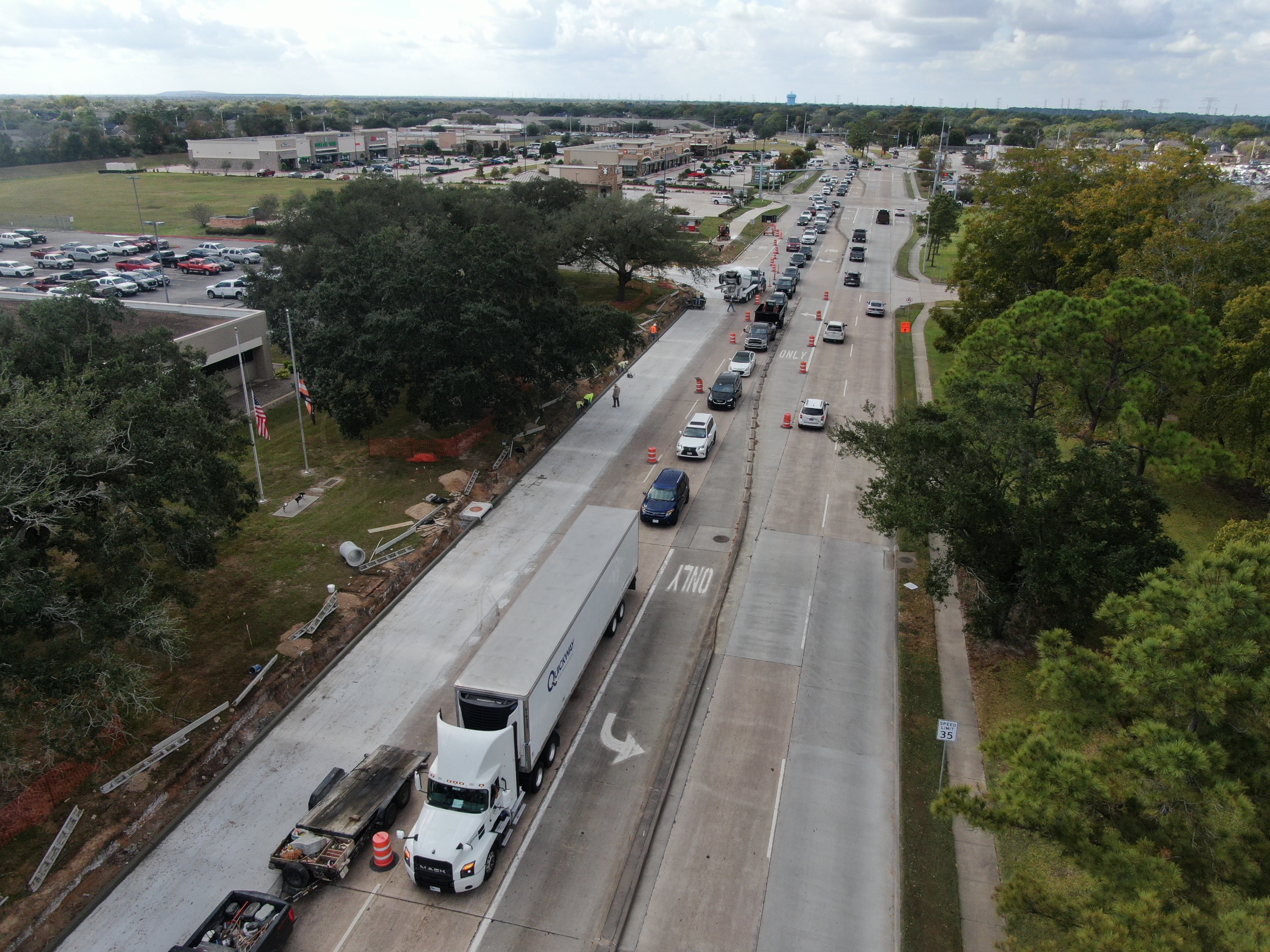

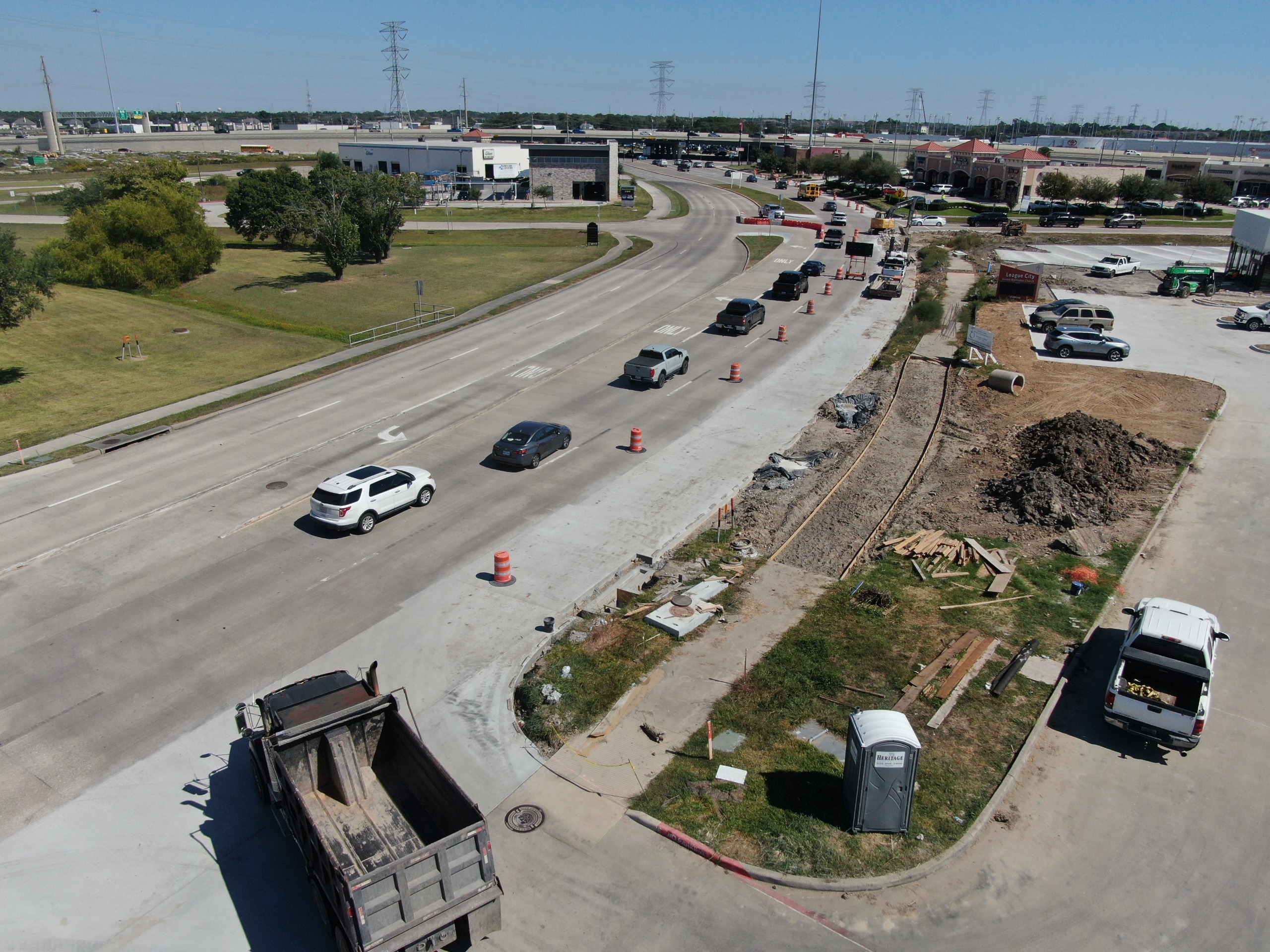

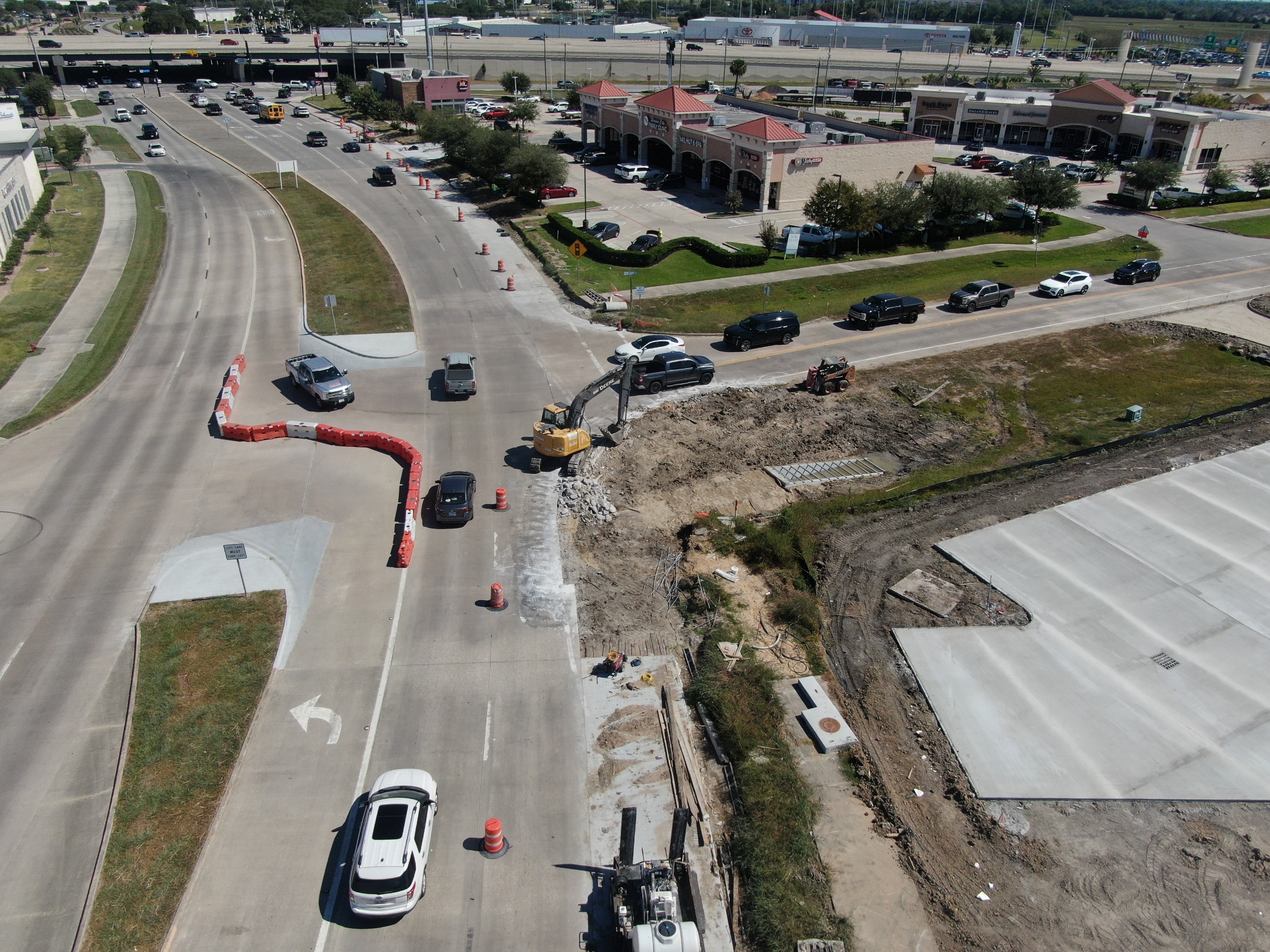

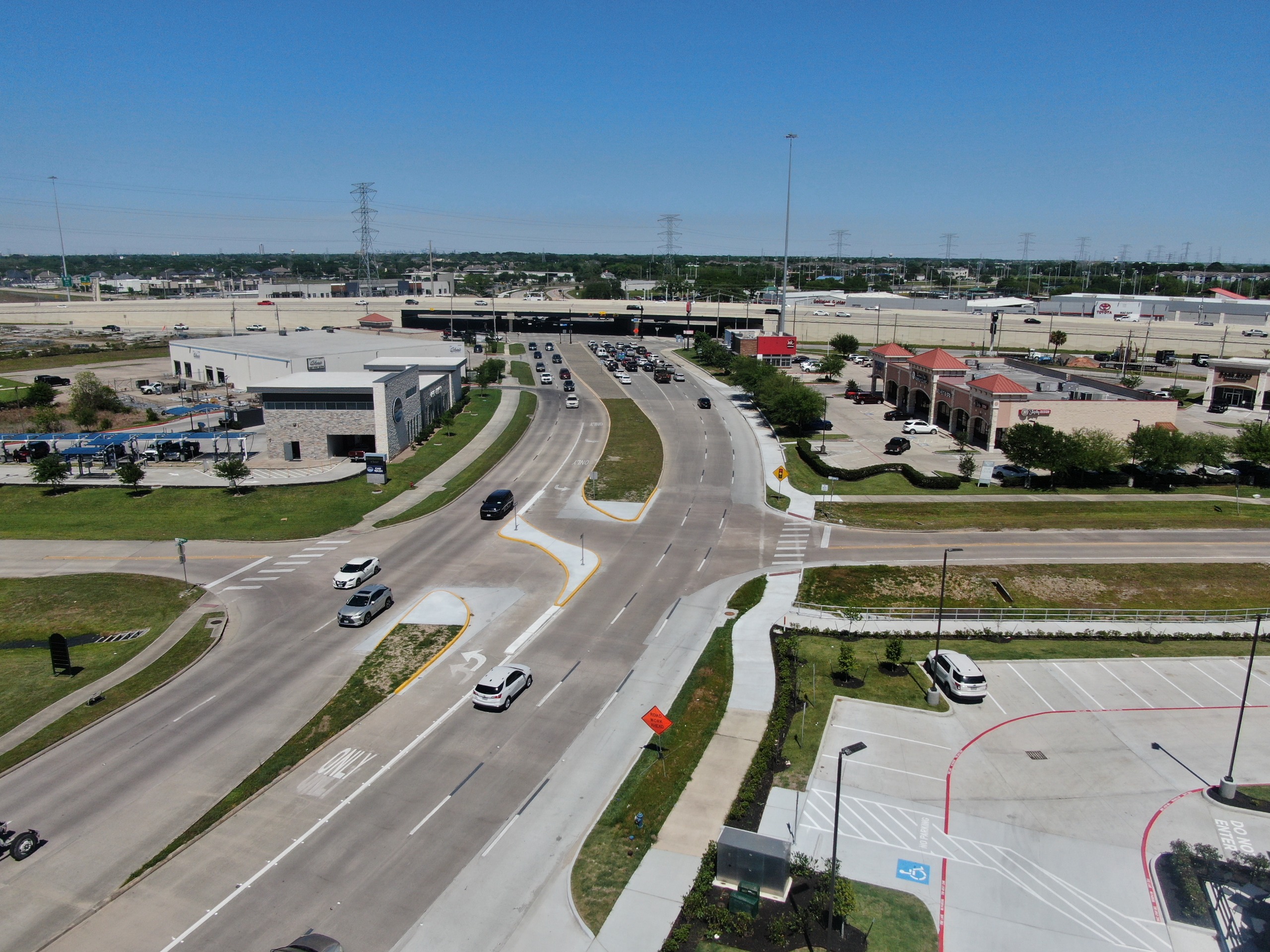

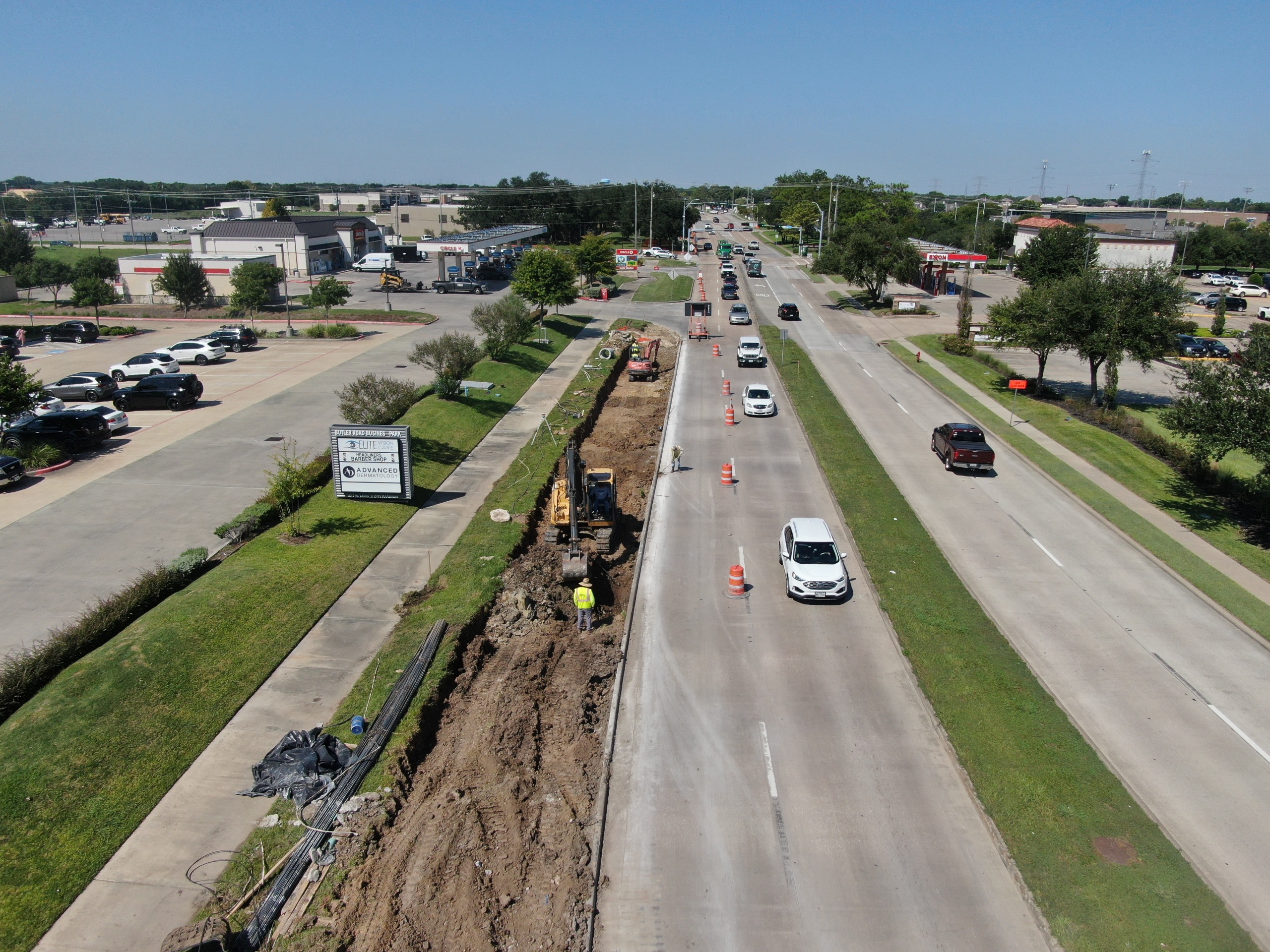

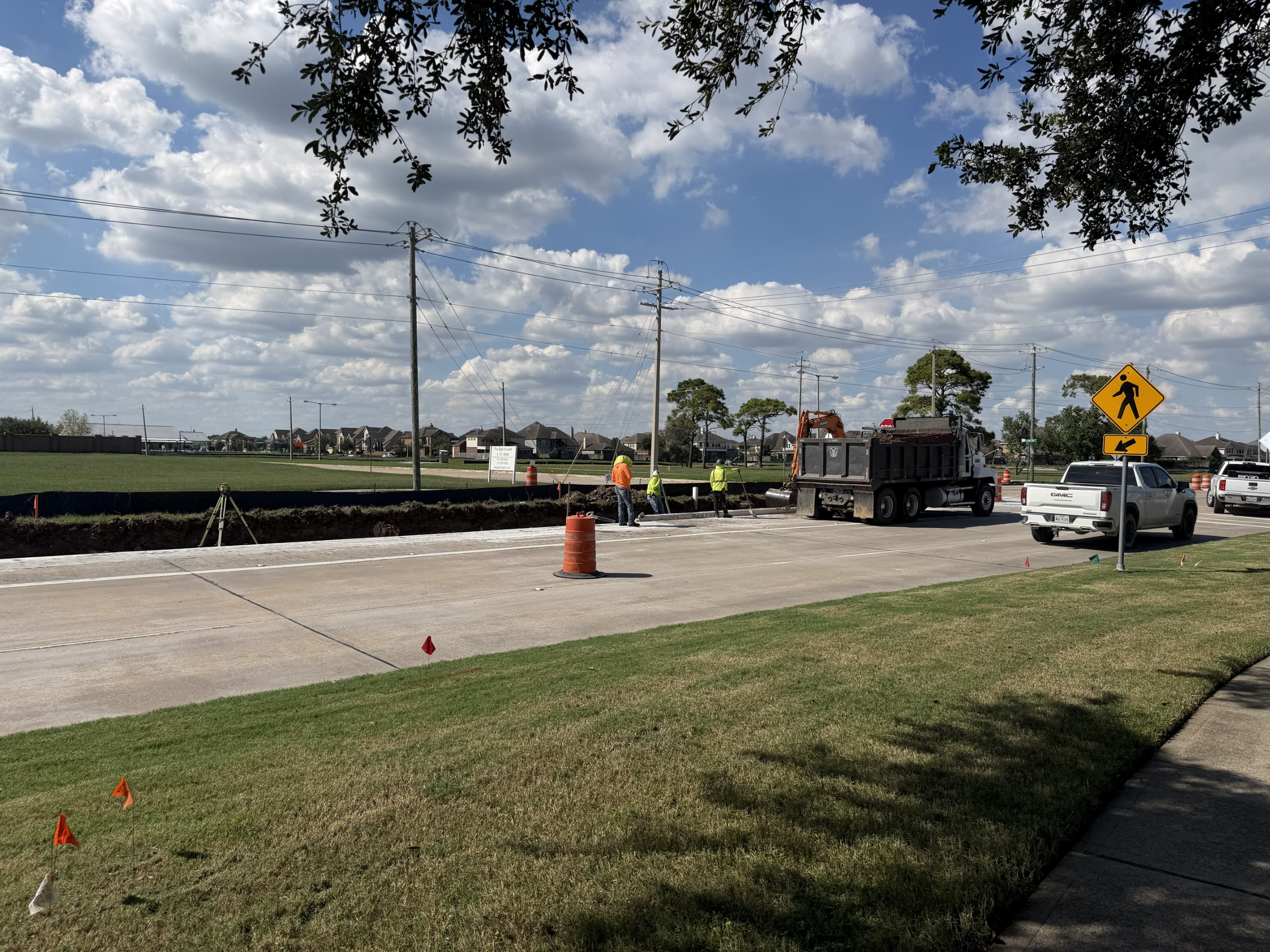

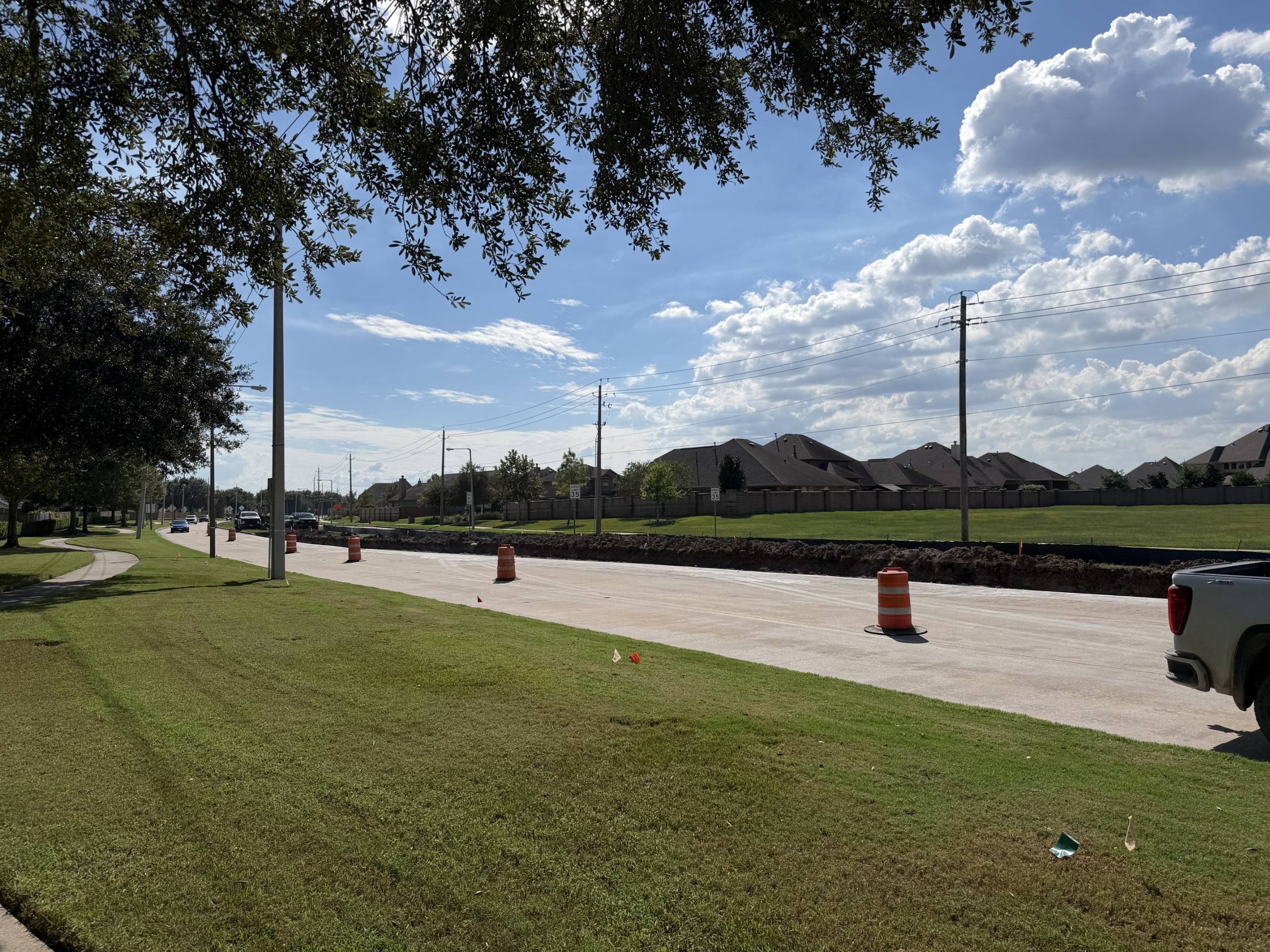

Photo Update:
Maple Leaf & League City Parkway
This project includes additions of an exclusive northbound right-turn lane, an exclusive westbound right-turn lane, and a traffic signal installation at the intersection of Maple Leaf Drive and League City Parkway.
Capital Improvement Project Budget: $1,396,806
Project Timeline:
- Current Status: Bid Phase January 2026
- Design Phase Completed: October 2025
- Construction Phase: Anticipated March 2026
- Substantial Completion: Anticipated May 2027

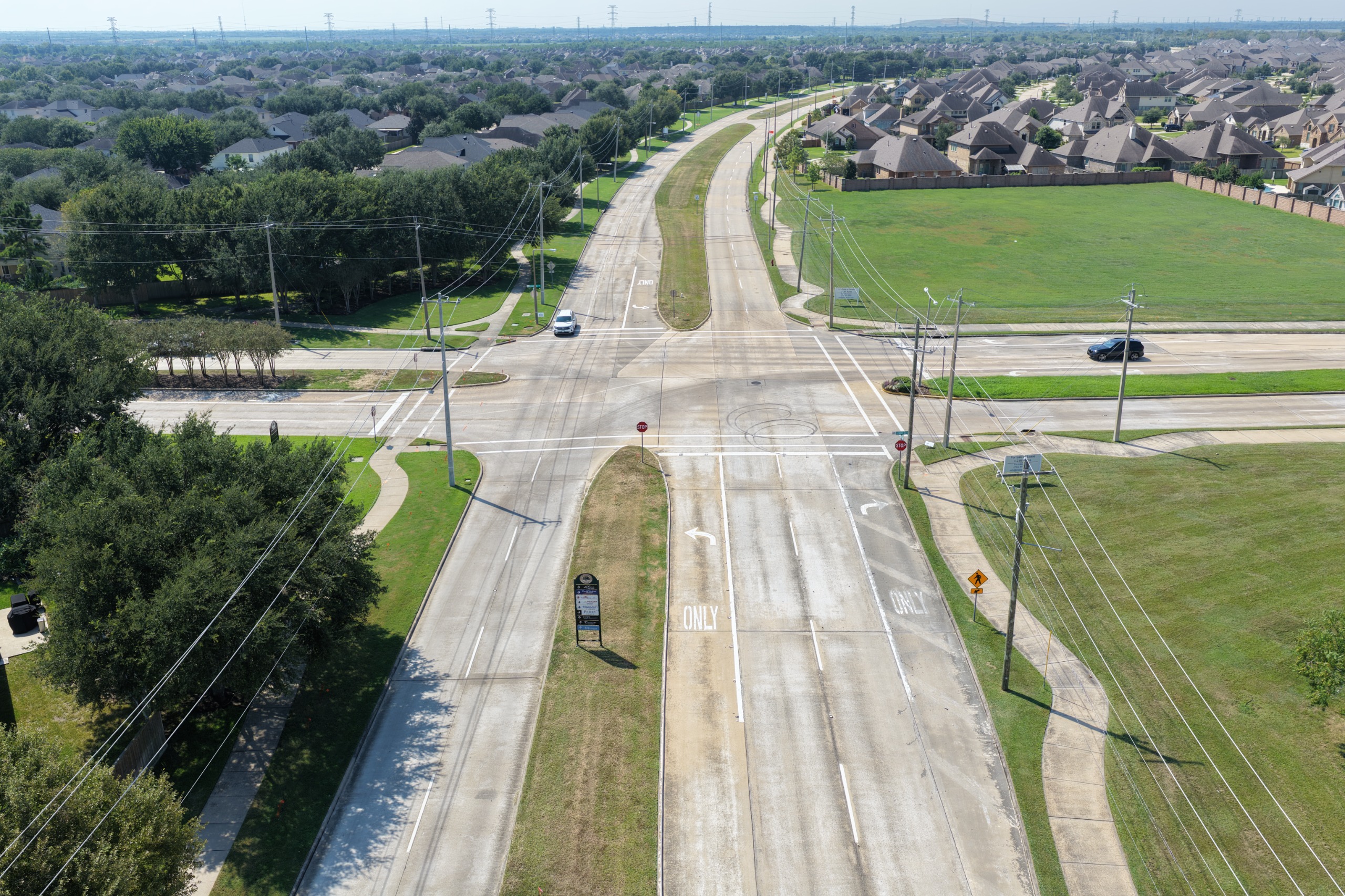

Photo Update:
Once project is under construction photo updates will be available.
Lawrence Rd and Village Way
The project includes the reconstruction of the traffic signal at the intersection of Lawrence Road and Village Way, with an addition of a southbound left-turn lane.
Capital Improvement Project Budget: $615,000
Project Timeline:
- Current Status: Bid Phase January 2026
- Design Phase Completed: November 2025
- Construction Phase: Anticipated March 2026
- Substantial Completion: Anticipated January 2027

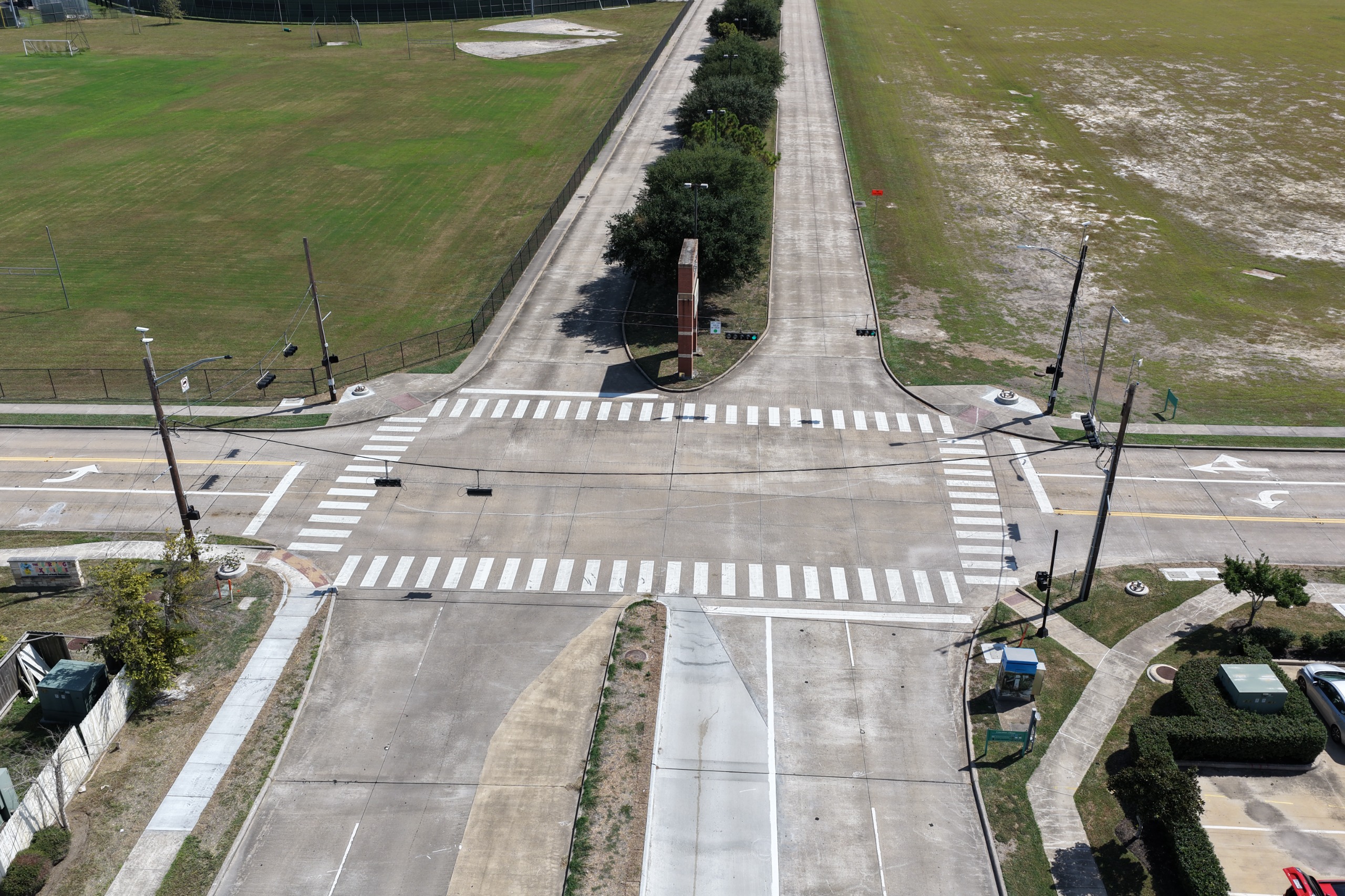

Photo Update:
Photo updates will be available once construction has begun.
FM 518 and Bay Area Blvd
This project improves intersection capacity and safety by adding a long southbound right turn lane and extending the existing northbound left turn lane.
Capital Improvement Project Budget: $647,598.00
Project Timeline:
- Current Status: Design Phase February 2026
- Bid Phase: March 2026
- Construction Phase: Anticipated May 2026
- Substantial Completion: Anticipated May 2027
Photo Update:
Photo updates will be available once construction has begun.

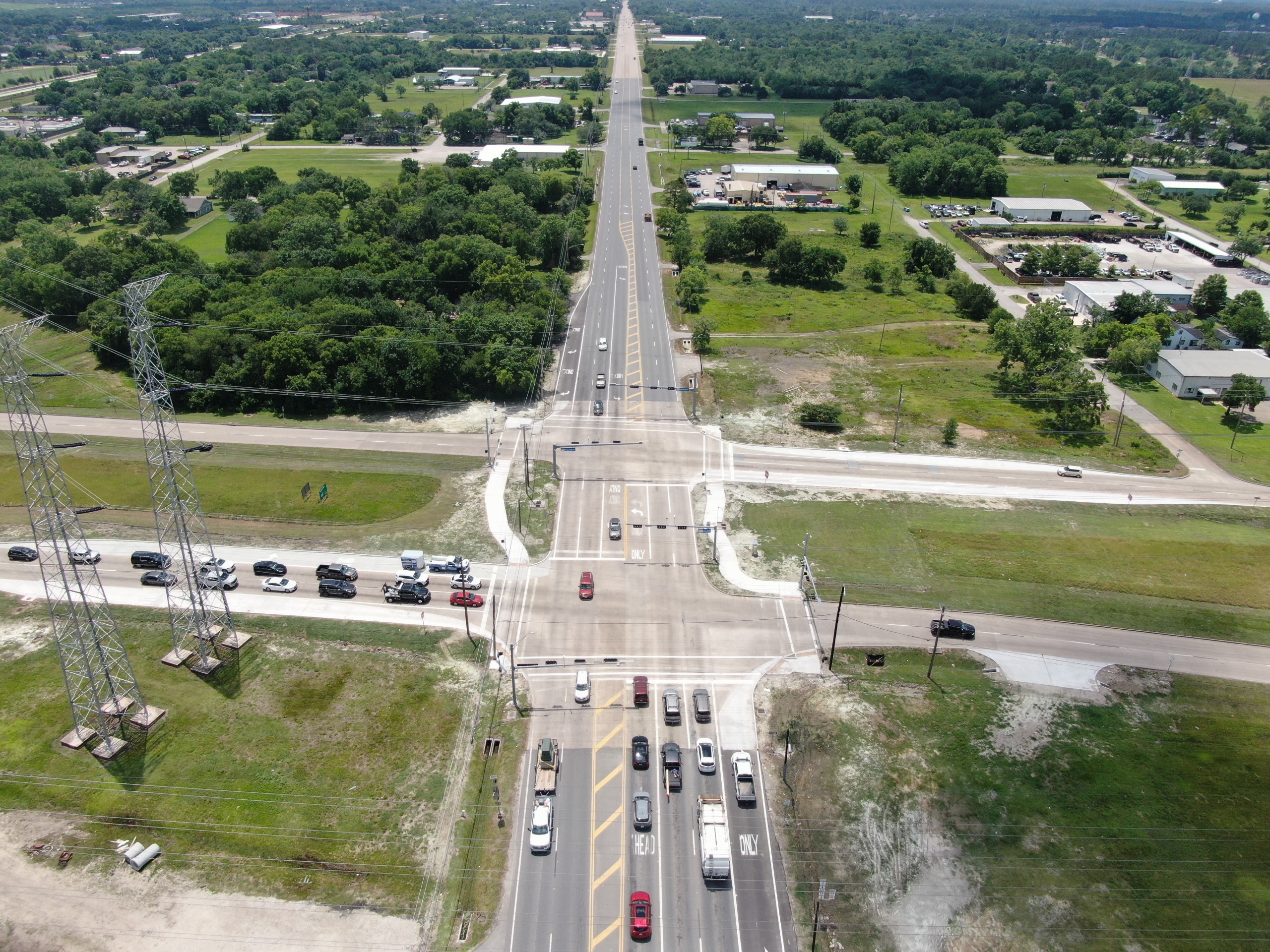

Walker Street & League City Parkway
Traffic improvements at the League City Parkway and West Walker Street intersection includes new turning lanes for the entire intersection, extension of the existing turn lanes, and correction to the cross grade of the intersection.
Capital Improvement Project Budget: $2,762,910
Project Timeline:
- Current Status: Design Phase January 2026
- Bid Phase : February 2026
- Construction Phase: Anticipated June 2026
- Substantial Completion: Anticipated June 2027
FM 518 and Country Lane:
This project will remove and replace of all four signal poles, pedestrian poles, pavement markings and traffic cabinet at the intersection of FM 518 and Country Lane. It includes pedestrian ramps on the north side of the intersection and the southeast corner will be provided with associated crosswalks. Sidewalk improvements to connect to existing facilities is also integrated into the neighborhood south of the intersection.
Capital Improvement Project Budget: $600,000
Project Timeline:
- Current Status: Construction March/April 2026
- Design Phase: Completed April 2024
- Bid Phase: Completed June 2025
- Substantial Completion: Anticipated October 2027
Photo Update:
Once project is under construction photo updates will be available.
